Construction





Work in progress


Completion of a big project like the busway creates change and some disruption. We’re keen to be good neighbours while the work is in progress and to keep you updated so you know what to expect.


Check below for current and upcoming road layout changes and work in your area while the Eastern Busway is built.


Where
Activity
What’s happening
From
To
Pakūranga to Mattson Road

Brampton Court (off Pakūranga Road)

day and night work

Restarting intersection work. This includes night work on the opposite side of Brampton Court and the construction of a median traffic island. Temporary pedestrian detours will be in place.

13 July

late August

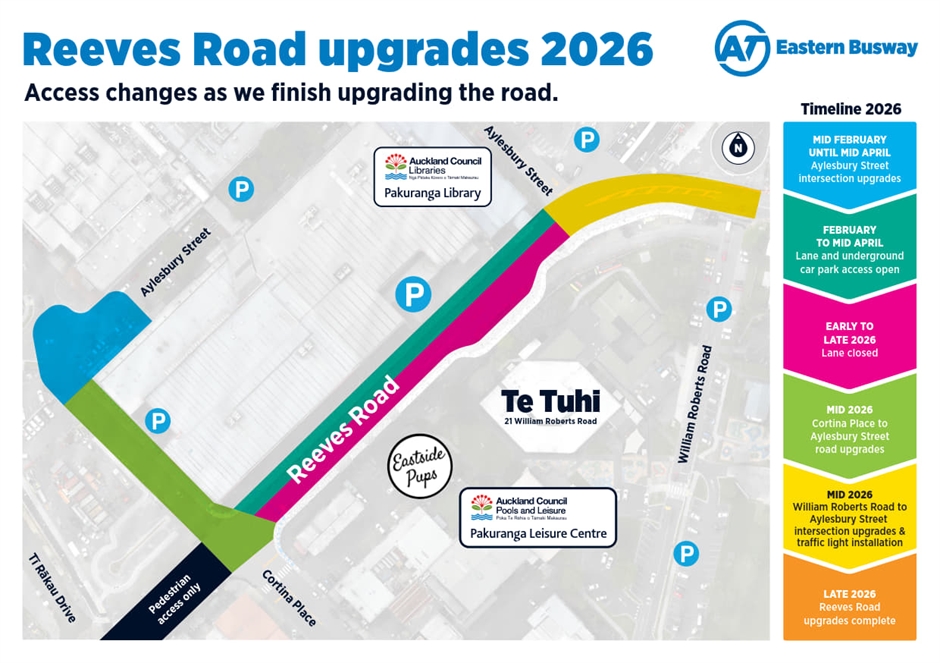

Reeves Road/ Aylesbury Street/ William Roberts Road intersection

day and night work

Road closure from 20 July to early September

- Two-way stop/go traffic on Reeves Road.

Drainage upgrades and installation of fully signalised intersection

*Various closures are required to complete this work.

8 June

early November

Aylesbury Street, Cortina Place and Reeves Road within the Pakuranga Plaza

Night work

Final asphalt layer work. This work requires a road closure. Follow detour signs.

2 August

7 August

Tī Rākau Drive at the intersection of Tī Rākau Park/William Roberts Road

Day work

Stormwater and water main upgrades and pavements work. The William Roberts Road intersection will be reduced to one lane for traffic turning on to Tī Rākau Drive from Monday 3 August to Friday 7 August.

June

November

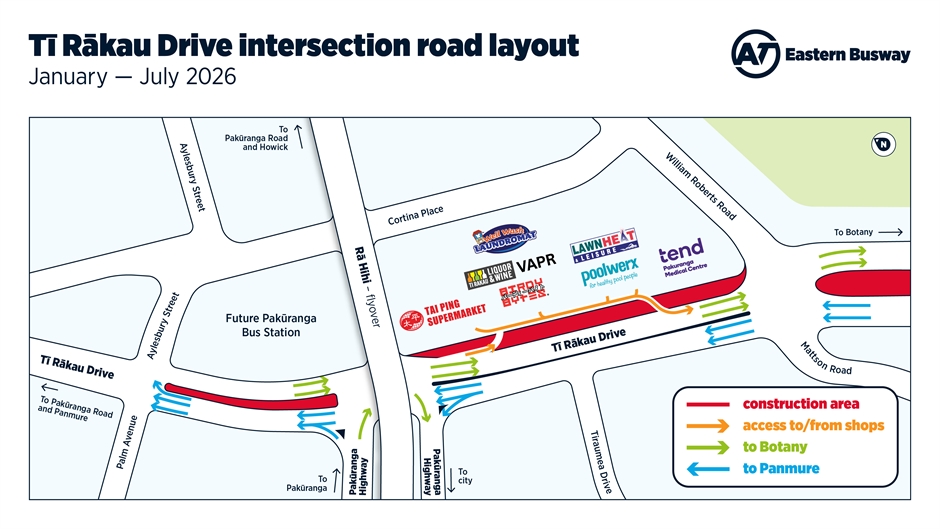

Pakūranga Road/ Tī Rākau Drive intersection

Night work

Pavements work on the Plaza corner of Pakūranga Road and Tī Rākau Drive.

2 August

10 August

Mattson Road to Tī Rākau bridge

84 to 214 Tī Rākau Drive properties

day work

Improving local stormwater network


15 June


mid-August

Between 178 and 208 Tī Rākau Drive

day work

Kerb reinstatement and final road surfacing works

27 July

7 August

Marriott Road

day work

drainage work

2 August

3 August

Between 154 to 176 Ti Rākau Drive

day work

drainage work

2 August

3 August

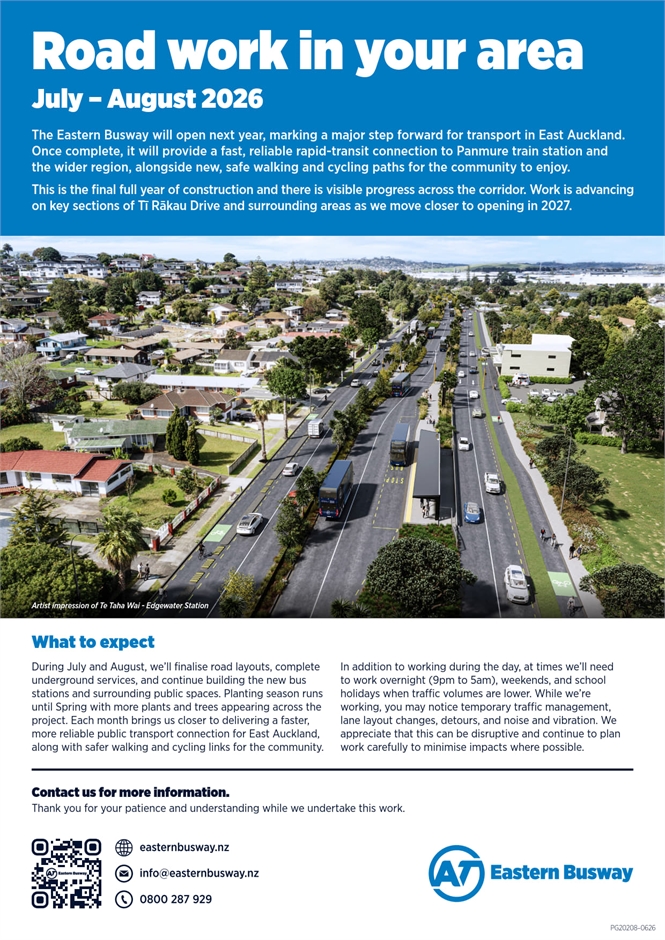

Te Taha Wai - Edgewater Station

night work

concrete pour at 2.30am (approx. 1 to 2 hours)

4 August

4 August

Tī Rākau Drive (eastbound)

day work

Footpath upgrades

late June

late August

Burswood, Huntington Park and Botany

Tī Rākau Drive

map

road layout changes

Lane changes on Tī Rākau Drive between Burswood Drive (east) and Te Koha Road near The Hub in Botany

March 2026

December 2026

Burswood

day work

Construction work during the day

September 2024

August 2026

Whakamaumahara

Guys Reserve

day and night work

Construction on final stage of Eastern Busway

March 2026

Mid 2027
